Northfield's $19 million high school overrun: what the record reveals
How bid results, board decisions, and district explanations leave key questions unresolved
Construction bids for the Reimagine Northfield High School project came in $19 million over budget on March 26.
The $19 million overrun appears nowhere in the official public record for the April 6 decision itself: not in the April 6 agenda, not in the April 6 board packet, and not in the April 6 meeting minutes. Only students’ families learned about it via email on April 7, the day after the consequential decision had already been made. On April 13, the board approved those minutes without comment and approved a second set of bid packages with no public discussion of the cost gap. When asked why the overrun wasn't included in the April 6 agenda, Superintendent Matt Hillmann's response was: "There is no specific reason. We just didn't include it."
The explanations for the overrun offered by Hillmann and the project’s consultants (tariffs, fuel prices, data center competition, and general market volatility) are only partially supported.
Redirecting long-term maintenance funds to cover the gap has implications for facilities across the entire district, not just the high school.
Under the district's Construction Manager as Adviser contract, the district absorbs all cost overruns directly. Both Knutson Construction and Wold Architects earn higher fees if the final project costs are higher.
The district has committed not to use general fund dollars for the overrun.
Full disclosure: In 2013, the district contracted with me for online civic engagement work on initiatives led by then-Director of Human Resources and Technology Matt Hillmann. In November, 2024, I voted for all three high school bond questions.
Why did a North Dakota high school construction project come in $4 million under budget the same week Northfield's high school came in $19 million over?
On March 23, 2026, West Fargo Public Schools opened construction bids for the expansion of Horace High School in Horace, North Dakota. The bids came in nearly $4 million below the district’s $34.4 million estimate. The school board approved the contracts the same day.
Three days later, on March 26, Northfield Public Schools (ISD #659) opened bids for the Reimagine Northfield High School project. The results stood in sharp contrast. Across 23 trade packages, bids came in 20 percent over projections, $19 million more than budgeted.
The two projects are genuinely different in scope, complexity, and mechanical systems, and those differences matter, as this post will explain. But both opened bids in the same week. Both use structural steel. Both use petroleum-derived materials. Both were subject to the same tariff environment and the same fuel price spike triggered by the Iran war, which began on February 28. That contrast on its face makes it harder to attribute Northfield’s outcome solely to broad market conditions.
What happened on bid day?
Bids for the Reimagine Northfield High School project were opened at 2:00 p.m. on March 26. The district had solicited bids across 23 separate trade packages, everything from structural steel and precast concrete to mechanical systems and site demolition. Seventy-seven bids came in total, which sounds like healthy competition until you look at the distribution. Three major packages, mechanical, structural steel, and masonry, drew only one or two bids each. Several others came in significantly over budget. When Knutson Construction, the district’s construction manager, added it all up, the bids were trending 20 percent over projections. In real dollars, that’s $19 million more than budgeted.
The bid results raise two separate questions: what caused the overrun, and how the district communicated it to the public. Both deserve examination.
What happened at the April 6 board meeting?

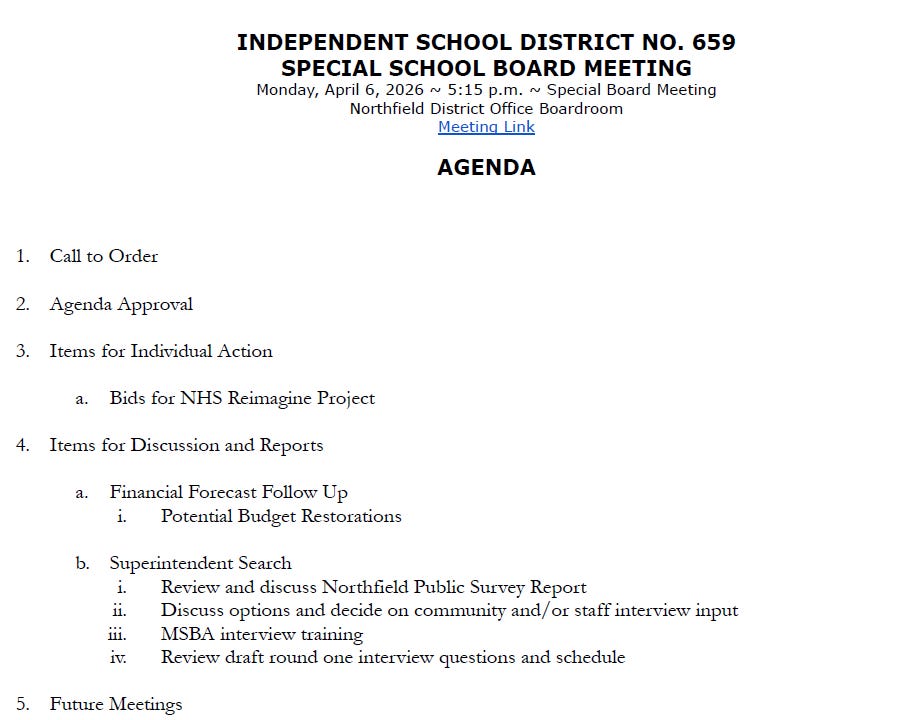

A special school board meeting was scheduled for April 6, eleven days after bid day. At that meeting, Josh Cooper of Knutson Construction and Sal Bagley of Wold Architects presented the bid results. Superintendent Matt Hillmann recommended that the board approve four of the 23 trade packages: structural concrete, precast concrete, roofing, and site demolition, earthwork, and utilities, for a total of $26.5 million. The board voted unanimously to approve them.

The remaining 19 trade packages, including mechanical, structural steel, masonry, electrical, and glazing, were not brought forward for award. Three additional packages were flagged as potentially ready for the next meeting. The status of the others remains publicly unclear.
Four board members contributed to the bids discussion. Amy Goerwitz noted that she had participated hands-on in the best-value bidding process the prior week and wished it had been applied to every package. Jenny Nelson pressed on whether advertising had reached contractors outside Minnesota and whether supply and installation had been bundled when they should have been separated. Ben Miller pushed for clarity on the go-forward strategy for packages that drew only one bid. Corey Butler pressed on the practical timeline, asking how long the remaining bids would remain valid, establishing that the district has roughly 60 days from March 26 to act on the outstanding packages before bids expire.

What the public record left out—three times
The April 6 discussion was not the board’s first exposure to some aspects of the bid process. Board member Amy Goerwitz noted she had participated hands-on in the best-value bidding process the prior week. It is also common practice for superintendents to brief board members individually before special meetings addressing matters of this significance.
The public had little reason to know that April 6 was a consequential meeting. The agenda, posted April 1, listed the item neutrally as “Bids for NHS Reimagine Project.”
The 85-page board packet contained the superintendent’s recommendation to approve four trade package contracts, with no mention of a $19 million gap between the budget and the bids from contractors. A diligent citizen reading every page of that packet would have had no reason to treat the item as urgent, controversial, or even particularly noteworthy. No citizens showed up to ask questions. The board voted unanimously to proceed.

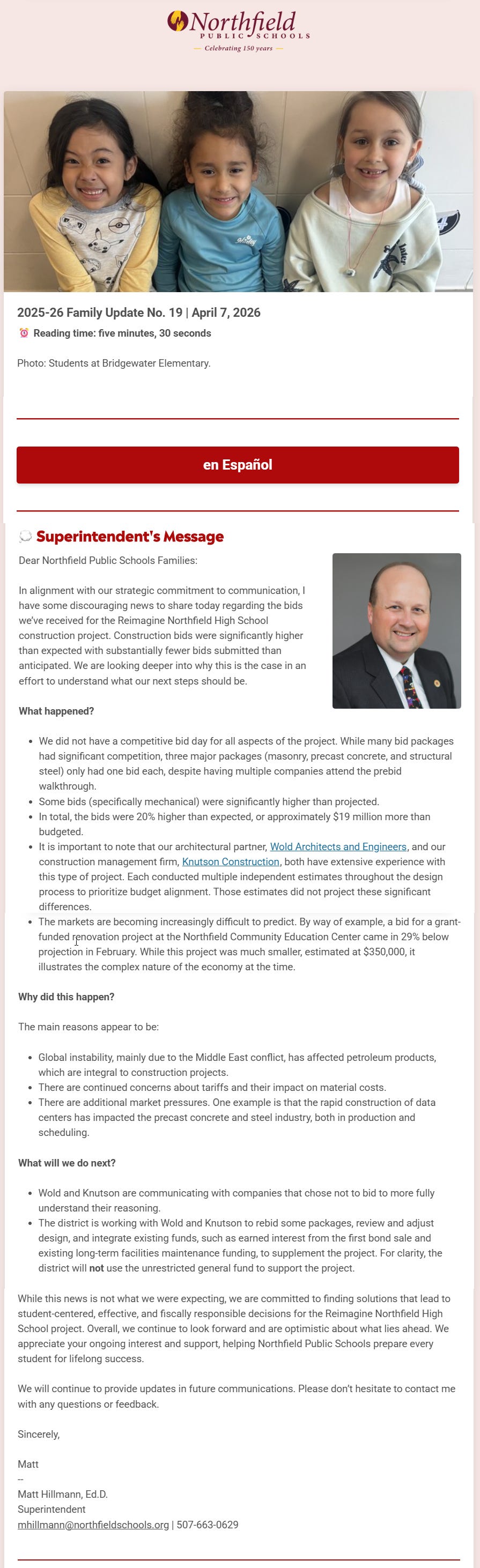

The following day, April 7, families with students enrolled in the district received a newsletter explaining that bids had come in $19 million over budget and that the district was working on a recovery plan. The family newsletter reaches households with students enrolled in the district. It does not reach the broader taxpaying public that voted for and will fund the project. By the time it went out, the board had already voted to approve four contracts, making starting over significantly less likely.
I asked Hillmann why the April 6 agenda hadn’t included the overrun information that was sent to families the following day. His answer: “There is no specific reason. We just didn’t include it.”
Posting an agenda item and a board packet that gives no indication of the stakes of a decision is not the same as informing the public. The community deserved to know before April 6, not after, that a $19 million gap had emerged between the budget and contractor bids and that the board was about to decide how to respond.

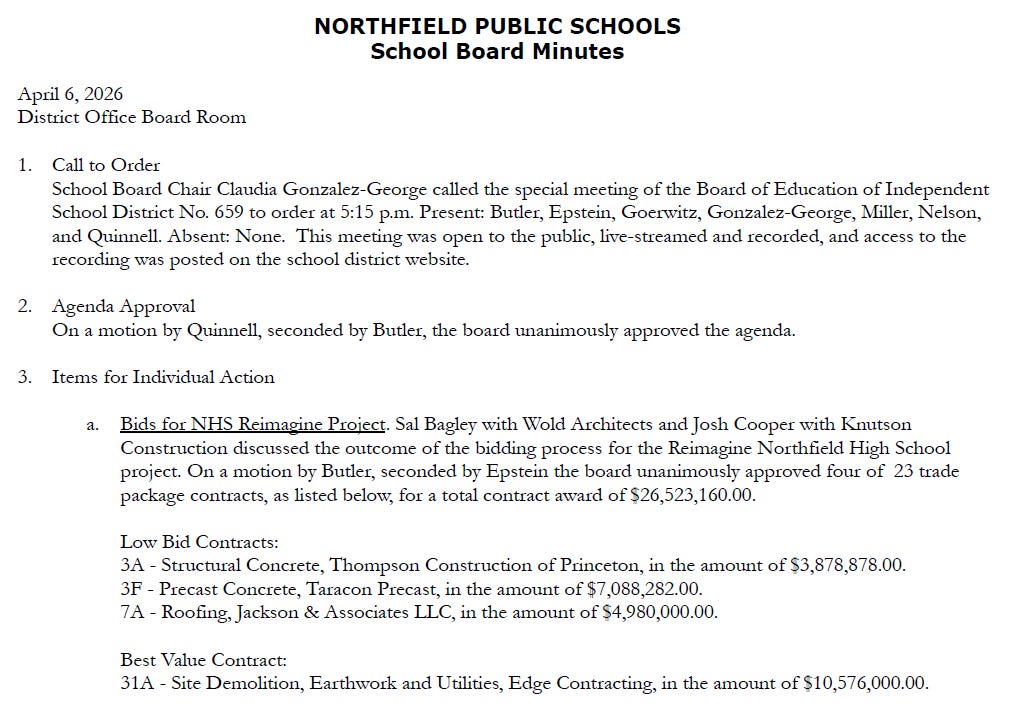

The official minutes of the April 6 meeting compound the gap. They make no mention of the bid overrun that prompted the special meeting. Hillmann’s response to that question is procedurally accurate: board minutes document governance, motions, and votes, not the substance of discussion. That is standard practice. But it means that for any resident consulting the official public record to understand what happened, the $19 million problem simply isn’t there.
The April 6 minutes were included in the April 13 regular board meeting packet for approval. The board approved them without comment. At that same meeting, the board approved a second set of bid packages for the project. There was no public discussion of the cost gap when those packages came forward. I asked Hillmann why. His answer was that the April 13 discussion was about those bid packages. That is true. It is also true that approving additional contracts on a project with a known $19 million gap between budget and bids is itself a consequential decision, and the public had no indication from the agenda or packet that it was one.

I also asked why the district’s April 10 Facebook and Instagram posts of the 2025-26 Family Update No. 19 email newsletter included no summary of its contents, no dollar figure, and no indication that it contained significant news about the project. Hillmann’s explanation is accurate: the district posts all email update newsletters to families to social media using the same format, and the April 10 post was consistent with that practice. Other family update posts are equally spare.
But the district is capable of writing descriptive, substantive social media text when it chooses to. The March 11 superintendent search post summarized the news, explained how community members could participate, and linked to a survey and virtual Q&A. The March 18 levy hearing reminder included date, time, location, and entrance instructions. The April 6 attendance post was detailed enough to include a ten-item checklist. Screenshots of Facebook posts are shown below, including a screenshot of the April 10 family update announcement on Facebook:

The question Hillmann’s explanation raises is not whether the April 10 post followed the district’s standard practice. It did. The question is why a $19 million gap between the approved budget and contractor bids was communicated through the family update mechanism, which, by design, produces a content-free social media post, rather than being announced directly, in the district’s own words, to the broader public that voted for and will fund the project.
Note #1: Complete texts of my email exchanges with Hillmann are available in footnote #1
Note #2: Hillmann objected to my use of the term "cost overrun.” He wrote:
One item for clarification. You have used the term “cost overrun.” The bids came in 20% higher than expected, but that doesn’t mean the costs will. We have only accepted a portion of the bids, as I explained in my last message. The district, Wold, and Knutson are working diligently to align the project’s scope with available funds.
That distinction is real. The outcome of those efforts may well close part of the gap. But a $19 million difference between the approved budget and the bids contractors submitted on March 26 is an overrun by any standard construction-industry definition, and calling it something softer would obscure what this analysis examines. At the April 6 meeting, Josh Cooper of Knutson used the term 'overages' to describe the same gap. Where final costs land is a different question, and one that I will return to as the district's recovery plan becomes public.
Note #3: Screenshot of the 2025-26 Family Update No. 19 email newsletter:
What explanations for the overrun has the district offered, and how well do they hold up?
At the April 6 board meeting, Hillmann, along with Knutson’s Josh Cooper and Sal Bagley with Wold Architects, presented four primary explanations for the overrun: global instability related to the Middle East conflict affecting petroleum products, tariff uncertainty on steel and other materials, competition from data center construction, and general market volatility. These explanations deserve scrutiny.
Did tariffs drive up costs?
The tariff explanation is the most substantive. Section 232 tariffs on steel and aluminum have been at 50 percent since June 2025 and remain in place. The broader picture on bid day was even more complicated: the Supreme Court struck down the IEEPA-based tariffs on February 20, just 34 days before bid day, and the Trump administration immediately replaced them with new, across-the-board tariffs under a different legal authority. For contractors pricing a multi-year project in that environment, genuine uncertainty about what tariff structure would govern their materials costs was real and documented nationally.
What about petroleum products?
The petroleum explanation has some validity, but it is weaker than it sounds for this specific project. Petroleum is not just a transportation fuel; it’s an ingredient or manufacturing input in a wide range of construction materials: roofing membranes, sealants, adhesives, insulation, PVC piping, waterproofing products, paints, and coatings.
A spike in oil prices eventually flows through to the prices of those materials. Contractors bidding a multi-year project also factor in forward risk, not just what materials cost today, but what they might cost over three and a half years of construction. That’s a legitimate bidding consideration.
Even so, the timing makes it less likely that the February 28 oil shock was a primary driver of the March 26 results on its own. Contractors had less than four weeks to reprice bids around a disruption whose full supply-chain effects typically take months to materialize. This doesn’t mean petroleum is irrelevant to the project’s costs going forward. Rebidding and future construction phases may well feel that pressure. But as an explanation for what happened specifically on March 26, four weeks is not enough time for that shock to have fully worked its way into contractor bids.
Did data center competition thin the bidder pool?
The data center competition explanation is harder to evaluate from publicly available information. There is currently only one hyperscale data center under active construction in Minnesota: the Meta (Facebook’s parent company) facility in Rosemount.
Precast concrete suppliers have repositioned toward the data center market nationally, which may affect their overall scheduling priorities. But the direct causal link between national data center activity and thin-bidder participation on a Northfield school project remains unverified.
The district’s construction manager has spoken with contractors who attended the pre-bid walkthrough but didn’t submit bids. What those contractors actually said has not been made public, and it is the most relevant evidence available for evaluating this explanation.
What about the mechanical contractor market?
The explanation that has received the least public attention but may account for a disproportionate share of the overrun involves the mechanical contractor market.
The Northfield project includes a geothermal heating and cooling system, a major and ambitious component of the renovation. Industry surveys document a nationwide shortage of qualified geothermal drillers, with most HVAC contractors reporting difficulty finding drilling partners for geothermal projects. Retrofitting geothermal into an active school campus is more complex and expensive than installing it in new construction. For a project of this scope in Minnesota, the pool of qualified mechanical contractors willing and able to bid may simply be narrow, independent of tariffs, fuel prices, or data centers.
Hillmann acknowledged in his email response to this post that "with the exception of precast, the other packages were within the anticipated range,"a characterization that concentrates the overrun in the mechanical packages. The district has not broken that down publicly.
What about general market volatility?
In his email to district families, Hillmann offered a Northfield example to illustrate market volatility: a $350,000 district renovation project at the Northfield Community Education Center came in 29% below its budget in February 2026, six weeks before high school bid day. He meant this to show how unpredictable the market is. It also shows that the same regional market was producing significantly under-budget results at the same time. The NCEC project was a small interior renovation with a single prime contractor, a different market segment from a $96 million multi-package construction program. Volatility is a description of market conditions, not an explanation for why professional cost estimates missed by $19 million on a project whose construction manager has been engaged since January 2025.
Who bears the financial risk, and how are the professionals paid?
The district’s contract with Knutson Construction, which I obtained through a public records request, directly answers the cost-risk question. The contract is a Construction Manager as Adviser (CMA) arrangement, not a Construction Manager at Risk (CMAR).
Under a CMA, the district holds all trade contracts directly and absorbs cost overruns. The construction manager provides expertise, coordination, and administration throughout the project and collects a management fee. Under a CMAR, the construction manager holds the trade contracts and assumes financial responsibility for cost overruns above a guaranteed maximum price, creating a direct financial incentive to estimate conservatively. Under a CMA, that incentive does not exist. The district bears the cost risk; the construction manager does not.
Knutson’s Construction phase fee is set at 1.70% of total construction costs, to be added via a change order. At the original budget of approximately $96 million, that fee totals roughly $1.6 million. If the project ultimately costs $19 million more, Knutson earns an additional $323,000. The contract also specifies that if bids exceed the budget and the district chooses to revise scope or rebid packages, Knutson is required to perform that rebidding and redesign coordination work without additional compensation.
Wold Architects’ fee is structured similarly. Their December 2024 letter to the district sets a base services fixed fee of 7.5 percent of estimated construction costs. At the original $96 million estimate, that fee totals approximately $7.2 million. If the project ultimately costs $19 million more, Wold earns an additional $1.4 million.
None of this implies that either firm’s estimates were influenced by that fee structure. Cost estimating for a project of this complexity involves genuine uncertainty, and Section 6.2 of the Knutson contract explicitly states that the construction manager cannot and does not warrant that bids will not vary from the owner’s budget. That is standard contract language. But the structure is what it is, and the community should know it exists for both firms.
Neither firm competitively bid for this project. Wold’s engagement extended an existing master contract with the district. Knutson’s contract is a fresh standalone agreement with no reference to a prior master arrangement. Both were retained based on their performance on the 2018 bond projects, which the district’s Reimagine website states were completed for $2 million less than projected and finished on time despite 60 percent of the project schedule occurring during the COVID-19 pandemic. That track record was Hillmann’s stated basis for continuing both partnerships without a new competitive process.
Hillmann’s rationale was grounded in documented experience with Knutson and Wold, and arguably understandable at the time. Whether the decision to forgo competition on a project more than twice the size of the 2018 work was justified, especially since neither firm had delivered a geothermal system for this district before, is now a question the community can evaluate with the benefit of hindsight.
How does the district plan to close the $19 million gap?
Three strategies have been identified. First, rebidding some packages, in some cases by splitting supply and installation into separate contracts to attract more bidders, and in others by resequencing project phases to make the work more competitively priced. Second, design changes. Hillmann has been explicit that some scope will change, though what specifically has not been disclosed publicly. Third, supplemental funding from two existing sources.
The first supplemental source is approximately $4 million in additional funds above the original project cost estimates. At the April 27 board meeting, Finance Director Val Mertesdorf clarified that this figure is not straight interest earnings. It combines a bond premium from the initial bond sale, which came in more favorably than projected, with investment earnings on bonds already sold and projected earnings on the May bond sale. The district's original financial estimates were conservative, and the bond sale performed better than anticipated.
The second is long-term facilities maintenance revenue, a state per-pupil formula that generates approximately $1.3 to $1.4 million annually for the district.
The math on those supplemental sources leaves a significant gap. Four million dollars in supplemental funds plus some portion of annual LTFM funding falls well short of $19 million. The remainder has to come from design reductions, meaning some things voters expected to see in the finished project may not be there.
But there is a less-discussed implication of redirecting LTFM dollars toward the high school overrun. That funding exists to maintain facilities across the entire district, not just the high school. The district maintains a board-approved 10-year plan that allocates LTFM dollars to specific projects: roof replacements, boiler upgrades, flooring, windows, plumbing, and electrical systems across every school in Northfield. When those dollars are redirected to close a high school bid gap, something on that 10-year plan gets deferred.
Hillmann pushed back on that framing at the April 27 meeting. He said the district has always planned to braid LTFM funds into the Reimagine project, and that in past construction projects LTFM was used as a value-add to stretch what voters approved. In this case, he said, it will be used to protect the project rather than enhance it. He also said the district’s other buildings are in excellent condition and that other updates will still be possible over time.
The district has said clearly that it will not use the unrestricted general fund and cannot exceed its bond authority ceiling. Those are real constraints. What is less clear is what the finished project will look like once value engineering is complete, and what deferred maintenance in other buildings the community is implicitly accepting as part of the solution.
What specifically is on the current LTFM 10-year plan? Which buildings are affected by redirecting those funds? Which maintenance projects get pushed back, and by how many years? How many years of LTFM funding is the district considering redirecting? These are questions the district should answer publicly because the consequences extend beyond the high school to every building in the district. Parents of elementary and middle school students have a stake in this, too.
What happens next, and when will the public know more?
The regular school board meeting on Monday, April 27, included the Reimagine project as Item 8c under Information, listed as Construction Update No. 25. Sal Bagley of Wold Architects attended and presented alongside Hillmann. Bagley reported that the design team and Knutson have been meeting regularly since bid day and are currently working through nearly 150 line items for potential cost savings, ranging from product substitutions and resequencing to scope changes. No decisions on those items have been made yet. Eight of the 23 trade packages have now been awarded, including the original four plus fire suppression, geothermal wells, glazing, and electrical approved at the April 13 meeting. The major packages still outstanding are mechanical, structural steel, and masonry, the same packages that drove the overrun. Nothing has gone out for rebid as of April 27.
The current target is to finalize change decisions within the next few weeks, update construction drawings, and complete a three-week bid period, with the goal of receiving new bids before the end of June. Groundbreaking remains scheduled for June 9.
That timeline is tight given that bids from March 26 expire around May 25, though no information has been made public about whether the district plans to request extensions.
There is also a leadership transition to navigate. Hillmann announced in February that he will leave at the end of the school year to lead the Minnesota Association of School Administrators, effective July 1. Whoever the board hires as his replacement will inherit this project mid-recovery, with major procurement decisions still ahead.
As the recovery plan takes shape, two questions stand out:
Once the recovery plan is finalized, what will the finished project actually include compared to what voters approved?
Which projects on the LTFM 10-year plan get deferred, and for how long, if and when those dollars are redirected to the high school?
Hillmann has committed to sharing the path forward publicly once it's finalized.
Sources:
Superintendent Hillmann’s April 7 family newsletter; his April 14 interview on KYMN Radio with Rich Larson; the April 6 special school board meeting transcript; the April 13 regular school board meeting minutes; the Knutson Construction bid results letter to the board; the bid tabulation for all 23 trade packages from the March 26 bid opening; the AIA C132 Standard Form Agreement between ISD #659 and Knutson Construction Services Rochester, Inc., signed January 7, 2025, obtained through a public records request; Wold Architects and Engineers’ December 3, 2024 letter to Superintendent Hillmann setting out fees for the Reimagine project; the best value scoring matrices for the earthwork, glazing, mechanical, and electrical packages; the April 27 regular school board meeting packet, including Construction Update No. 25; and independent research on national construction market conditions in Q1 2026.
Email exchanges with Superintendent Matt Hillmann:
On Thu, Apr 23, 2026 at 7:10 AM Griff Wigley <griff@northfield.org> wrote:
Hello, Matt.
I’m preparing a post for Northfield.org on the bid results for the Reimagine Northfield High School project and the district’s response. I’ve attached a PDF of the current draft.
The post is an analytical account of what happened, grounded in the public record: the board minutes, the Knutson bid results letter, your April 7 family newsletter, and your April 14 KYMN Radio interview. I welcome any response you’d like to offer, and would consider including it in the post.
I am also sending a separate public records request to the district for two documents: the contract between ISD 659 and Knutson Construction for construction management services on the Reimagine project, and the complete bid tabulation results for all 23 trade packages from the March 26 bid opening. You are copied on that request. The draft is subject to change depending on what those documents contain.
Please respond by Friday, April 25 at 4 pm. If I don’t hear back by then, I’ll publish the post as written, subject to any revisions prompted by the records request.
I am planning to publish this weekend.
Thank you,
Griff Wigley
Editor, Northfield Citizens Online / Northfield.org
On Thu, Apr 23, 2026 at 10:26 AM Matt Hillmann <mhillmann@northfieldschools.org> wrote:
Griff,
Always good to hear from you, my friend.
I wanted to acknowledge your message, and I appreciate the courtesy of allowing me to review it ahead of time. You will receive a form from Val Mertesdorf for the records request. I will review the post and get back to you — but I wanted you to know I’ve got the message.
Sincerely,
Matt
On Fri, Apr 24, 2026 at 6:42 AM Griff Wigley <griff@northfield.org> wrote:
Matt,
I wanted to send you a revised draft reflecting two significant changes since yesterday’s version.
I’ve split the board discussion into two separate sections -- one covering what happened at the April 6 meeting, and a new section titled “What the public record left out -- twice” documenting that the $19 million overrun appears neither in the April 6 agenda/board packet nor in the official meeting minutes.
The attached PDF replaces yesterday’s version, but it’s still a draft. I’ve yet to add photo captions and misc links.
Griff
On Fri, Apr 24, 2026 at 11:38 AM Matt Hillmann <mhillmann@northfieldschools.org> wrote:
Hi Griff,
Again, thanks for the courtesy of sharing the post ahead of publication. I appreciate that very much. The district is committed to the successful completion of the voter-approved Reimagine Northfield High School project. It will be a substantial improvement for our students and community. Here are a few thoughts on your post:
While there also may be other factors, construction industry volatility, including tariff impact, global conflict and the ensuing instability on things like petroleum prices, and the recent impact of data center work are what appear to have had the greatest impact on bid day.
The bid packages approved on April 6 are essential for maintaining the project schedule. With the exception of precast, the other packages were within the anticipated range. Wold and Knutson believed it was important to award the precast package, even though its bid was higher than expected. This decision was influenced by market pressures, particularly related to data center construction, as you mentioned.
The district, along with Wold and Knutson, is working diligently to determine the best path forward. This may involve rebidding some project packages and collaborating with contractors to find savings through changes in project scope. As these details become clearer, we will determine how to incorporate Long-Term Facilities Maintenance (LTFM) into the project. Our process is carefully considered to ensure we proceed in the most fiscally responsible manner. Once we finalize this path forward, we will share the information publicly.
I appreciate your interest in comparing projects. However, as you noted, each project is unique. The North Dakota project you mentioned seems to have a significantly different scope and timeline. Another example is from right here in Northfield. We had a much smaller ($350,000) grant-funded renovation project at the NCEC in Feb. 2026 that received bids approximately 30% lower than expected. This also highlights the volatility in the construction market.
In alignment with our strategic commitment to communication, the district takes pride in maintaining transparency in our operations and keeping the public informed. I understand your concern about including the overall cost gap in the board packet. For clarity, while bids were opened on March 26, not all the analysis was completed that day. The best-value process is time-intensive and involves thorough interviews with bidders, which were completed on Friday, April 3. In hindsight, I should have included our message to families in the April 13 packet. That said, we did clearly articulate the cost gap in multiple communications, including our family updates, which we also post on our website and enhance their visibility by sharing them on the district’s Facebook account. I also discussed this issue in detail during my regular appearance on KYMN. As always, we will continue to prioritize transparency.
Again, thanks for sharing your post before publication. I am grateful for that.
Sincerely,
Matt
On Sat, Apr 25, 2026 at 2:23 PM Griff Wigley <griff@northfield.org> wrote:
Matt,
I have four follow-up questions related to communications about the overrun.
1. The interviews with bidders were completed on April 3. Why wasn’t a table file agenda item added at the April 6 meeting that included the details of the overrun -- the same information you intended to send to families on April 7?
2. Why didn’t the April 6 meeting minutes include any mention of the overrun discussion?
3. The April 6 minutes were included in the April 13 board packet for approval. They contained no mention of the overrun discussion. Yet the board approved them. And when the board approved a second set of bid packages at that meeting, there was no public discussion of the cost gap. Why?
4. The district’s April 10 Facebook post said only that Family Update No. 19 had been emailed to families, with a link. No summary, no image, no indication of what the update contained. The Instagram post similarly ended with “Read the update at the link in our bio.” Given that this was an unexpected $19 million overrun on a voter-approved project, why were the social media posts so minimal about what the update actually said?
Griff
On Sun, Apr 26, 2026 at 4:20 PM Matt Hillmann <mhillmann@northfieldschools.org> wrote:
Hi Griff,
I hope you’ve had a good weekend. Thanks again for your courtesy as you prepare your post.
One item for clarification. You have used the term “cost overrun.” The bids came in 20% higher than expected, but that doesn’t mean the costs will. We have only accepted a portion of the bids, as I explained in my last message. The district, Wold, and Knutson are working diligently to align the project’s scope with available funds.
1. The interviews with bidders were completed on April 3. Why wasn’t a table file agenda item added at the April 6 meeting that included the details of the overrun -- the same information you intended to send to families on April 7?
There is no specific reason. We just didn’t include it. I acknowledge we could have done so and appreciate your pointing it out. As you know, we promptly informed the community through our family update on April 7 that was also posted to our website and, soon thereafter, on our social media channels.
2. Why didn’t the April 6 meeting minutes include any mention of the overrun discussion?
Our board minutes document the board’s governance, motions, and actions taken. The minutes don’t generally include the details of the accompanying discussion.
3. The April 6 minutes were included in the April 13 board packet for approval. They contained no mention of the overrun discussion. Yet the board approved them. And when the board approved a second set of bid packages at that meeting, there was no public discussion of the cost gap. Why?
As I said above, the minutes for April 6 were consistent with our regular practice — the minutes document the board’s governance, motions, and votes. The agenda item that evening was approval of the next set of bid packages. The discussion was about those bid packages.
4. The district’s April 10 Facebook post said only that Family Update No. 19 had been emailed to families, with a link. No summary, no image, no indication of what the update contained. The Instagram post similarly ended with “Read the update at the link in our bio.” Given that this was an unexpected $19 million overrun on a voter-approved project, why were the social media posts so minimal about what the update actually said?
We post our family updates to our social media accounts using virtually the same language each time. This was posted in the same way that we post all other family update publications. We also post family updates to our district website shortly after it is emailed to families. Also, we’ve recently launched a process to allow community members without students in the district to sign up to receive the family update via email.
Again, the district takes pride in maintaining transparency in our operations and keeping the public informed in alignment with our strategic commitment to communication. I am grateful for your questions about the board packet and can assure you that I will consider the sentiment behind them to drive continuous improvement.
Sincerely,
Matt
See the latest Northfield.org posts in the archive.

Want to keep up with the discussion? Tap the ❤️ on this comment, and Substack will nudge you when there’s activity.
KYMN Radio, May 12: What’s next for the “Reimagine Northfield High School” project?
https://kymnradio.net/2026/05/12/whats-next-for-the-reimagine-northfield-high-school-project/
